Regional mobility authorites (RMAs) are not directly
accountable to the people of Texas. No voter approval is
required for their creation; no voter approval is
required for the selection of their board members or
staff; no voter approval is required for the selection
and funding of their toll projects; nor is voter
approval required for “conversion,” as it is called in
transportation planner’s language.[6]
Comptroller Strayhorn has repeatedly said, “the
redesignation as toll roads of roads already
constructed, under construction or funded through
traditional means, such as the gasoline tax, is double
taxation.”
Travis and
Williamson counties created the
Central
Texas Regional Mobility Authority (CTRMA) in the wake of
2001 legislation allowing counties to create regional
mobility authorities, or RMAs, to finance, build,
operate and maintain toll roads and other transportation
projects. CTRMA is a two-county political subdivision of
the state, authorized to operate in its jurisdiction by
the Texas Transportation Commission (TTC).[7]
The
CTRMA
board includes seven members, with three
each appointed by the commissioners courts of
Travis and
Williamson counties and a seventh member appointed by
the governor to serve as chairman (Exhibit 1).
The terms of all
CTRMA board members expired as of
February 2005. Williamson County has reappointed its
current members. At this writing,
Travis County has not
yet made its appointments, and the governor has not
designated a new chair. When these appointments are
complete, two of the six county-appointed members will
serve two-year terms; two for four years; and a final
two, along with the chair, will serve six-year terms.
All subsequent member terms will be for six years,
giving the board staggered six-year terms.
Appendix 2
provides a timeline of significant events in
CTRMA’s
short tenure.
Questions have surfaced regarding the
constitutionality of the six-year duration of terms for
all RMA board members, as they are described in the
RMA’s governing statute, Chapter 370 of the
Transportation Code. The six-year terms of
RMA board
members may be held to violate Article XVI, Section
30(a) of the Texas Constitution, an issue raised by
litigation filed on March 2, 2005 in Travis County
District Court. The section says, “The duration of all
offices not fixed by this Constitution shall never
exceed two years.” On its face, this provision could
invalidate the service of CTRMA’s board members and, in
the extreme, invalidate past decisions by those members.
The Legislature should consider legislation to approve
retroactively CTRMA board decisions and amend the Texas
Constitution to set the terms of
RMA board members at
four years to avoid any uncertainty that may result from
an unfavorable court or attorney general ruling.
The Capital Area Metropolitan Planning Organization
(CAMPO), a 23-member body consisting primarily of
elected officials from Travis,
Williamson and Hays
counties, must approve CTRMA projects (Exhibit 2).
Like all metropolitan planning organizations, CAMPO is
required by federal law to approve all transportation
plans in its region that receive federal funding.
EXHIBIT 2
Capital Area Metropolitan Planning Organization
Members |
Member |
Representing |
Gonzalo Barrientos, Chair |
State Senator, District 14 |
Greg Boatright, Vice Chair |
Williamson County Commissioner
|
Steve Ogden |
State Senator, District 5 |
Dan Gattis |
State Representative, District
20 |
Dawnna Dukes |
State Representative, District
46 |
Terry Keel |
State Representative, District
47 |
Todd Baxter |
State Representative, District
48 |
Elliott Naishtat |
State Representative, District
49 |
Mark Strama |
State Representative, District
50 |
Eddie Rodriguez |
State Representative, District
51 |
Mike Krusee |
State Representative, District
52 |
Sam Biscoe |
Travis County Judge |
Karen Sonleitner |
Travis County Commissioner |
Gerald Daugherty |
Travis County Commissioner |
Bill Burnett |
Hays County Commissioner |
Will Wynn |
City of Austin Mayor |
Daryl Slusher |
City of Austin Council Member
|
Brewster McCracken |
City of Austin Council Member
|
Danny Thomas |
City of Austin Council Member
|
Nyle Maxwell |
City of Round Rock Mayor |
Dwight Thompson |
Alliance of Cities Mayor |
John Trevino |
Capital Metro |
Bob Daigh |
TxDOT (District Engineer) |
Source: Capital Area Metropolitan Planning
Organization. |
The CAMPO board includes 21 elected officials as well
as one representative from the Capital Metropolitan
Transportation Authority (Capital Metro) and one from
the Texas Department of Transportation (TxDOT). (Capital
Metro is a transit authority established in 1985 by
Austin-area voters that uses the proceeds of a one-cent
local sales tax to provide public transportation within
its jurisdiction.)
While Hays County is represented on CAMPO, the county
has not petitioned TTC to join CTRMA or to create its
own RMA, although it still could choose to do either.
CAMPO coordinates regional transportation planning
with TxDOT, area cities and counties, Capital Metro, the
Capital Area Rural Transportation System (which provides
public transport services in Austin-area rural areas)
and other transportation providers.
Since its beginning,
CTRMA has worked closely with
TxDOT to create its construction plan, and its
operations depend heavily on TxDOT development and
funding; Travis and Williamson Counties provided some
early, but relatively limited financial assistance.
On April 12, 2004,
CTRMA and TxDOT presented the
authority’s proposed regional implementation program to
CAMPO. This identified the greater Austin area’s
immediate mobility needs and proposed toll-road projects
for
CTRMA to operate or develop (Exhibit 3).
EXHIBIT 3
CTRMA and TxDOT
Initial Project List
|
US 183-A: San Gabriel to SH 45 North
|
SE 45: SE US 183 to IH 35
|
US 290 phase of the “Y” in Oak Hill
|
US 183 / SH 71: IH 35 to the Airport
|
Loop 1 US 290 to William Cannon
|
SH 45: Loop 1 to FM 1626 (4 lanes)
|
SH 71 phase of the “Y” in Oak Hill
|
LP 360: RM 2244 to south of Walsh Tarlton
|
US 290: US 183 to SH 130
|
Loop 360: Loop 1 to US 290
|
Note: Since this list was made public, CAMPO has
deferred funding to the Loop 360 project and
removed the toll-road designation from Loop 1
(US 290 to William Cannon).
Sources: Central Texas Regional Mobility
Authority and Texas Department of
Transportation.
|

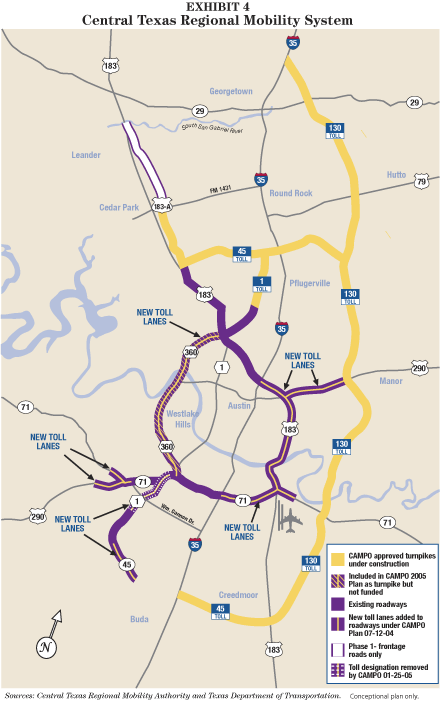

Exhibit 4 illustrates
CTRMA’s and TxDOT’s road
plan, the Central Texas Regional Mobility System.
CTRMA’s proposed regional implementation program
includes projects that were included in CAMPO’s
Transportation Improvement Program (TIP), a federally
required, three-year plan listing transportation
projects that can be developed with available funds.
CAMPO amended its TIP on July 12, 2004, expanding the
list of projects to include all of the toll-road
projects CTRMA and TxDOT had proposed.
As public knowledge of
CTRMA’s plan spread during
summer 2004, many Central Texas residents became
increasingly concerned about the plan’s reliance on toll
roads.
The most controversial part of the plan, judging from
news accounts and mail received by the Comptroller’s
office, was the proposed addition of tollbooths to the
section of Loop 1 (MoPac) crossing William Cannon Drive.
This segment touched off a particularly contentious
debate about what should or should not be tolled; what
constitutes “conversion” of a road; and just how the
state should fund highway construction and maintenance.
It should be noted that, despite
CTRMA’s close
involvement with TxDOT in developing a toll road network
for Travis and
Williamson counties, at present it is
directly responsible only for the construction and
operation of US 183-A. TxDOT is planning and building
the other roads in the region’s plan.
CTRMA officials
told the review team that these toll roads would be
turned over to the authority at a later date.
CTRMA

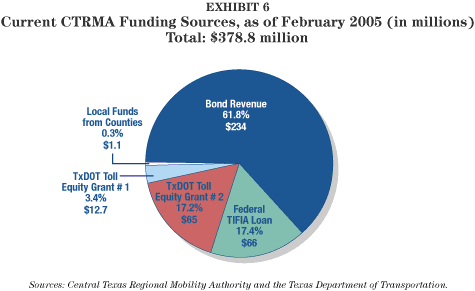

Funding
CTRMA developed its financial plan in cooperation
with TxDOT, CAMPO and the two counties’ commissioners
courts. The authority plans to rely on local, state and
federal revenue, bond revenue, toll revenue and may
receive private equity investment as well.

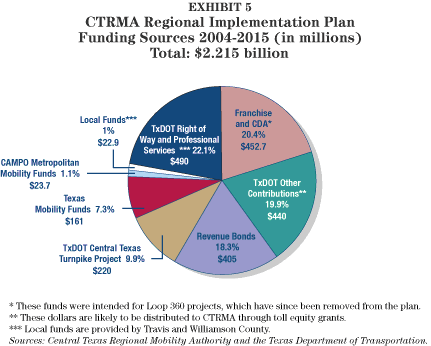

CTRMA’s proposed regional implementation program, as
presented to CAMPO on April 12, 2004, described a series
of funding sources extending through 2015, including
contributions from TxDOT, CAMPO, Travis and Williamson
counties, the newly created Texas Mobility Fund and
proceeds from revenue bonds.
CTRMA and TxDOT originally anticipated that $452.7
million in private equity would become available through
a comprehensive development agreement (CDA), an
arrangement authorized by the 2001 and 2003 Legislatures
that allows transportation authorities to contract with
private companies for the design, construction and
operation of road projects.
The proposed CDA identified in Exhibit 5
originally was intended to support projects on Loop 360.
As of this writing, the CDA has been pulled from the
plan due to CAMPO’s decision to defer funding issues
related to this project to a later date.
TxDOT
Contributions
TxDOT contributions to the
CTRMA regional
implementation plan will come from the State Highway
Fund.
The fund’s primary purpose is to receive money
allocated for the construction of roads and the
maintenance of state highways. The fund’s primary
revenue source is state and federal motor fuel tax
collections, although other fees and taxes generate some
state dollars for the fund.
TxDOT also will contribute funding earmarked for the
Central Texas Turnpike Project (CTTP), a planned network
of four toll roads in the Austin area, including SH 130,
SH 45 North, Loop 1 extension and
CTRMA’s US 183-A.
TxDOT removed US 183-A from the CTTP to allow
CTRMAto
develop the road as its first project. CAMPO approved
these toll roads in 2000 and TxDOT is financing the
construction of the project’s first phase, including
Loop 1, SH 45 North and the northern 49 miles of SH 130.[8]
TxDOT believes the SH 130 project will be less
expensive than originally estimated, and plans to make
the resulting savings available to
CTRMA after calendar
2007. No funds from this source, however, have been
allocated or are anticipated for use in financing US
183-A.
TxDOT has stated it also will provide
CTRMA with
rights of way and professional services. Rights of way
are acquired through the purchase or condemnation of
land. TxDOT can either acquire rights of way or
reimburse cities and counties for acquiring them in the
state’s name.
The review team could not establish what percentage
of the $490 million devoted to rights of way and
professional services in Exhibit 5 will actually
be used for right of way acquisition. Repeated requests
to the Texas Transportation Commission (TTC) failed to
yield the needed information. Similarly, the review team
could not establish what “Professional Services”
actually includes.
Both right of way and professional services will be
funded through TxDOT’s Austin District budget.
Toll
Equity Grants
TxDOT’s contributions to
CTRMA are likely to be made
in the form of toll equity grants, funds made available
under the Transportation Code for the “cost of the
acquisition, construction, maintenance, or operation of
a toll facility of a public or private entity.”[9]
In the past, TxDOT was authorized to provide these
funds only as loans. In 2001, however, S.B. 342 removed
the obligation of repayment. TxDOT now can contribute up
to $800 million annually in toll equity grants to
transportation projects and has recommended that the
Legislature remove this cap.[10]
CTRMA already has received two toll equity grants
from TxDOT to support the US 183-A project. On April 24,
2003, TxDOT awarded CTRMA $12.7 million to begin design
work on the road.[11]
The grant was not provided as a lump sum, but instead
reimburses CTRMA for various expenses as they are
incurred.
TTC approved a second toll equity grant on December
16, 2004, to help pay for the construction and initial
operations of US 183-A. As of this writing, TTC has
authorized a grant of between $52 million and $65
million. The exact grant amount will be subject to
CTRMA’s financial need after it sells revenue bonds.
This grant is intended to help the authority cover
construction costs and its operating and maintenance
costs during the first years of US 183-A’s operations,
until its toll revenue becomes sufficient. The grant
should give CTRMA the financial flexibility it needs to
meet its obligations to bondholders.[12]
Toll
Equity Limitations
The 2003 grant came with restrictions spelled out in
an agreement between CTRMA and TxDOT. According to this
agreement, the grant is:
...to be used for the study and development of the
proposed US 183-A turnpike project to the extent
necessary to secure financial closing, including
costs related to: (1) project management; (2)
contract negotiation and preparation; (3)
preliminary engineering; (4) securing federal
funding; (5) preparing an investment grade traffic
and revenue study; (6) the services of legal counsel
and rating agencies; and (7) incidental
administrative and other expenses.[13]
During an expenditure audit of
CTRMA’s use of this
first grant, however, TxDOT found that the agreement
failed to stipulate whether the funds could be used for
general administrative costs. The authority subsequently
agreed to use reimbursements from the grant to fund no
more than half of its general administrative costs.
CTRMA and TxDOT entered into the financial assistance
agreement governing the second toll equity grant on
February 3, 2005. According to the agreement,
CTRMA
would have wide latitude to expend these funds for the
construction, operation or maintenance of US 183-A, and
the funding would “not be subject to future
discretionary actions of TxDOT.”[14]
This flexibility underlines the importance of the toll
equity grant to the US 183-A financial plan.
Other restrictions related to TxDOT funding
categories (2, 11 and 12) are detailed in
Appendix 3.
Texas
Mobility Fund
Central Texas transportation projects also are
expected to receive revenue from the Texas Mobility
Fund, which was created by the 2001 Legislature to
support state revenue bond issues for transportation
projects.
While TxDOT officials have stated in public hearings
that regional mobility plans do not necessarily have to
include tolls in order to receive money from the Texas
Mobility Fund, other evidence suggests the opposite.
Transportation Commissioner Robert Nichols has been
quoted as telling State Representative Joe Pickett of El
Paso that, “El Paso could lose some of its Texas
Mobility Fund money if other communities build toll
roads and have additional highway projects that they are
willing to build with toll revenue.”[15]

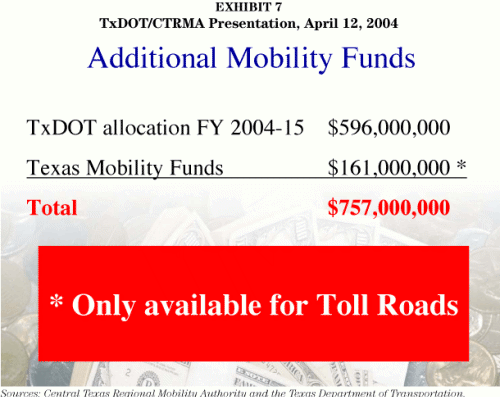

And an April 12, 2004 presentation on the proposed
TxDOT/CTRMA regional implementation program included a
slide specifically stating that Texas Mobility Fund
revenue would be made available only to transportation
plans containing toll projects (Exhibit 7).
CAMPO board member and Austin City Councilman Danny
Thomas was troubled by the same issue at the January 24,
2005 CAMPO meeting. He stated that, since CAMPO’s July
2004 vote to include additional toll roads, he has
repeatedly asked the TTC and CAMPO staff whether the
Austin area would have lost Texas Mobility Fund dollars
if it had not approved the additional toll roads. He
said that he had not yet received a straightforward
answer.
Travis County Commissioner and CAMPO board member
Gerald Daugherty agreed with Councilman Thomas and said
that he went to TTC meetings twice and was told if CAMPO
didn’t “do this Plan in its totality, that [they] will
lose, most likely, [their] Texas Mobility Fund
dollars...that if you don’t do this, then you will lose
$161 million” in promised mobility fund dollars.[16]
CTRMA Chairman Bob Tesch made the same point in an
October 20, 2004 letter to Austin Councilmember Brewster
McCracken. He said, “We are all acting in response to a
funding mechanism dictated largely by TxDOT, and we are
reacting to the policy statements and directives we
receive from the department.”
In the same letter he quoted a TxDOT staff member who
said, “...the staff of TxDOT feels that any deviation
from the existing plan may jeopardize the funding level
Central Texas could expect.”
Limitations on the Texas Mobility Fund
Bonds backed by the Texas Mobility Fund may be issued
for one or more of the following purposes:
-
to pay all or part of the costs of constructing,
reconstructing, acquiring and expanding state
highways, including any necessary design and
acquisition of right of way, in the manner and
locations determined by the commission that,
according to conclusive findings of the commission,
have an expected useful life, without material
repair, of not less than 10 years;
-
to provide participation by the state in the
payment of part of the costs of constructing and
providing publicly owned toll roads and other public
transportation projects that are determined by the
commission to be in the best interests of the state
in its major goal of improving the mobility of the
residents of the state;
-
to create debt service reserve accounts;
-
to pay interest on obligations for a period of
not longer than two years;
-
to refund or cancel outstanding obligations; and
-
to pay the commission’s costs of issuance.[17]
Local
Funds
State law does not require counties establishing
RMAs
to provide them with startup funding.
Travis and
Williamson counties did so, however, each providing
$550,000 to begin CTRMA operations. The city of Cedar
Park in Williamson County agreed to aid the county in
providing rights of way.
Williamson County’s contribution was delivered in two
parts. On March 1, 2003, the county provided a $250,000
grant “to pay for various expenses related to the
creation and initial funding” of
CTRMA during fiscal
2003.[18]
Williamson County transferred operational control of
this first sum to Prime Strategies, Inc., a county
consultant charged with the initial tasks involved in
establishing CTRMA.[19]
The funds originated from a 2001 county road bond
program.
On September 30, 2003,
Williamson County provided the
remainder of its funding, a second grant of $300,000.[20]
This allotment initially came from the county’s 2000
general obligation road bond program, although a
subsequent change in its interlocal agreement with
CTRMA
ultimately supplied the funds from county general
revenue.[21]
On August 8, 2004, the city of Cedar Park and
Williamson County entered into an interlocal agreement
to provide rights of way needed for US 183-A. Cedar Park
agreed to transfer all US 183-A right of way tracts that
it had acquired within its city limits to
Williamson
County for CTRMA’s eventual use.
Williamson County
agreed to acquire the remaining rights of way and turn
them over to CTRMA before construction begins.
Travis County also provided
CTRMA with an initial
$250,000 startup grant on June 4, 2003.[22]
The county transferred the entire amount directly to
CTRMA. A second grant of $300,000 on October 16, 2003
was intended to support CTRMA operations in fiscal 2004.
The second grant allowed CTRMA to spend the money for
“general administrative purposes.”[23]
In both cases, the grant money originally came from
Capital Metro’s Transportation and Mobility Enhancement
Fund, also called the quarter-cent rebate fund.
Limitations on Local Funds
In providing this startup funding, the Travis and
Williamson County commissioners courts agreed that
CTRMA
should not be unduly burdened with spending
restrictions, as they wanted to provide the young
authority with enough flexibility to meet unforeseen
problems.[24]
Since
CTRMA may use TxDOT toll equity grants to cover
only half of its administrative costs, it relies on
Williamson and Travis County funds for the remainder
until it secures bond proceeds. This motivated
CTRMA’s
executive director to renegotiate the terms of the
authority’s second, $300,000 grant from Williamson
County. The director feared that the money’s origin in a
2000 road bond program would prevent
CTRMA from spending
these funds exclusively on general administrative
expenses. To overcome this hurdle,
CTRMA and the county
amended their interlocal agreement. In effect,
CTRMA
returned the bond proceeds to Williamson County, which
replaced them with an equal amount of unencumbered funds
from the county general revenue fund.[25]
Since
Travis County’s funding originally came from
Capital Metro, the funds are subject to Capital Metro’s
spending restrictions. Principally, these require
CTRMA
to use the funds to support projects within Capital
Metro’s jurisdiction that enhance regional mobility. The
US 183-A project qualifies.
CTRMA’s interlocal agreements with its parent
counties also require it to spend county-provided funds
only on items described in the budgets it provides to
the counties, and to follow state purchasing laws in its
spending. CTRMA provides both counties with financial
reports on a monthly basis, describing operational costs
after they are incurred.
The only other significant restriction includes a
prohibition against using Travis County funds “for
entertainment, liquor or recreational activities.”[26]
This sort of restriction highlights the importance of
closely tracking expenditures by their source of
funding, a subject discussed in Chapter 3.
In addition, the in-kind right of way commitments
from Williamson County and Cedar Park came with specific
construction requirements and other progress measures
that will trigger the return of donated rights of way to
city and county control if CTRMA does not meet the
progress measures.
Revenue
Bonds
CTRMA issued approximately $234 million of bond debt
in the form of insured senior lien revenue bonds ($168
million) and bond anticipation notes (BANs-$66 million)
on February 16, 2005. BANs are short-term, interest
bearing securities. Standard & Poor’s gave the revenue
bonds an underlying rating of Baa3 and an insured rating
of Aaa. Another major rating agency, Moody’s, assessed
the underlying rating at BBB- and the insured rating at
AAA. Standard & Poor’s and Moody’s assigned ratings of
Aa3 and AA respectively to CTRMA’s uninsured BANs. These
investment grade ratings translated into
CTRMA achieving
an overall cost of financing of 4.6 percent.[27]
CTRMA intends to use the proceeds from this bond sale
for US 183-A’s construction, operations and initial debt
service.
The bond rating is based on the creditworthiness of
the issuing entity and the financial viability of the
project expected to generate the repayment revenue.
CTRMA’s creditworthiness is based on the revenue it
expects to receive from toll collections on US 183-A,
TxDOT grants, TIFIA loans and an assessment by the
market of CTRMA’s governance. The state and federal
contributions, while helping to establish the project’s
creditworthiness, do not obligate the state and federal
governments to assume responsibility for any default on
the authority’s part. The constituent counties are
similarly free of any obligation in case of default.
Vollmer Associates LLP, a
CTRMA consultant, performed
a traffic and revenue (T&R) study to develop revenue
estimates for the US 183-A project. This study was
critical in assessing the overall financial viability of
the project. One of the required assumptions for this
study was the toll rate CTRMA planned to charge. The
amount charged reflected 2007 dollars, when the toll
road is scheduled to open. The final Vollmer T&R study
indicated CTRMA would charge $2 to travel 12 miles from
SH 45/RM 620 to the northern terminus, averaging 16.7
cents per mile. The report acknowledged that the portion
of project north of FM 1431 would consist of non-tolled
frontage road with room for main tolled lanes to be
constructed at a later date. The study also identified
the most expensive segment of the project to be of a
trip between FM 1431 and Brushy Creek Road.
CTRMA would
charge $1.50 for this 1.5-mile trip, averaging $1 per
mile.[28]
CTRMA financial advisors used the results of the T&R
study to structure the financial plan for US 183-A. They
expect toll collections to begin in 2007, with the
authority able to rely exclusively on toll revenue for
annual debt service and operations and maintenance costs
by 2013.[29]
The early stage of a toll road project’s life, before
toll revenues mature, is called the “ramp-up phase.”
CTRMA plans to leverage multiple sources of revenue to
ensure that the authority maintains a minimum
revenue-to-primary debt service ratio of 1.75 each year
(the minimum ratio required by rating agencies to
certify the bonds as investment grade). During the later
years, CTRMA financial advisors expect this ratio to be
as large as 7.55, providing the authority with
significant flexibility if toll revenue doesn’t meet
expectations during the early years. To cover debt
service during the ramp-up phase,
CTRMA will use
“capitalized interest”—excess revenue derived from the
bond issue, over the anticipated cost of the project
itself—and BANs. CTRMA will also leverage a portion of
TxDOT’s second toll equity grant to cover ramp-up phase
operations and maintenance costs, thus freeing early
toll revenues to service its bond debt.
As mentioned earlier,
CTRMA insured the $168 million
in senior lien bonds. CTRMA’s financial advisors
considered bond insurance vital, as they were concerned
that there would not be a market for uninsured bonds
issued by a start-up toll road authority. Financial
Guaranty Insurance Company (FGIC) insured the revenue
bonds at a cost of approximately $9 million to
CTRMA.
The insurance helped CTRMA obtain a better rating for
their bonds, thus reducing the total amount that the
authority needed to borrow to support the project.
Chapter 370 of the Transportation Code requires bond
principal and interest to be paid solely by:
-
the revenue of the transportation project for
which the bonds are issued;
-
payments made under an agreement with the
commission, the department, or other governmental
entity as provided by Subchapter G (toll equity
grants);
-
money derived from any other source available to
the authority, other than money derived from a
transportation project that is not part of the same
system or money derived from a different system,
except to the extent that the surplus revenue of a
transportation project or system has been pledged
for that purpose; and
-
amounts received under a credit agreement
relating to the transportation project for which the
bonds are issued.[30]
In 2008,
CTRMA may draw on its TIFIA loan to pay back
$66 million in BANs used to fund debt service during the
ramp-up phase. CTRMA’s integration of funds from such a
wide variety of sources indicates a strong commitment to
make its public dollars stretch as far as possible.
As other
CTRMA projects begin, similar bond issues
may be employed. Under the 2003 legislation, if toll
revenues from one project exceed debt service and other
obligations, the surplus can be used to fund new
projects.
Limitations of Revenue Bonds
The primary document governing the use of revenue
bond proceeds is the “trust indenture” between
CTRMA and
its bond trustee, the independent third party charged
with overseeing the terms of the agreement. This
agreement is a contract describing the financial
arrangements and binding each party to uphold certain
agreements.
CTRMA has developed a master trust indenture with its
US 183-A revenue bond trustee, JP Morgan Chase.
CTRMA
also has supplemental indentures for the 2005 series
revenue bonds and BANs issued for US 183-A. These
indentures outline how the bond proceeds can be spent
and CTRMA’s payment obligations to its bondholders.
Indentures are intended to secure the interests of
investors by clearly identifying the terms and priority
of repayment.
The supplemental trust indentures provide limits on
CTRMA’s uses of the revenue bond and BAN proceeds, such
as for costs associated with the “2005 project,” which
currently consists of only US 183-A, or for bond
issuance costs, or even for the cost of “studying,
evaluating and designing additional turnpike projects.”[31]
The trust indentures establish separate accounts for
the variety of uses of bond revenue, such as a
construction account or debt service account.[32]
These accounts inform investors how
CTRMA
will manage
the revenues and costs associated with the bond issue
and the US 183-A project.
CTRMA
is obligated to adhere
to this structure. The supplemental indentures also
provide specific restrictions, such as prohibiting
CTRMA
from using bond proceeds in any way that would
jeopardize the bonds’ tax-exempt status.[33]
In addition, the bond agreements identify a priority
for CTRMA’s expenditure of toll revenue. The agreement
requires the authority to use toll revenue to sustain
the project’s operating and maintenance (O&M) needs
before paying bondholders. After these O&M needs are met
and the investors receive their annual debt service
payments, CTRMA may use the remaining revenue for other
purposes, including future road projects.[34]
Another significant restriction in the bond
agreements is a “covenant not to build competing
systems.”[35]
This restriction is in the master trust indenture and
therefore will apply to all subsequent bond issues. The
covenant obliges CTRMA to refrain from participating in
or building any motor vehicle transportation system, or
part of such a system, that might compete with US 183-A
for revenue.
The covenant is intended to protect the bondholders’
investment in US 183-A, and is vital to maintaining the
bonds’ rating. This provision, however, also effectively
prevents CTRMA from improving vehicular mobility in the
vicinity of US 183-A.
CAMPO
Metropolitan Mobility Funds
According to the regional implementation plan, CAMPO
has committed $23.7 million in highway funds within its
authority to CTRMA transportation projects. These
dollars will be used for projects that were in CAMPO’s
original TIP, before the July 2004 amendment. None of
these CAMPO funds, however, will be used on the current
US 183-A project.
Limitations on CAMPO Mobility Funds
CAMPO must follow a complex series of state and
federal restrictions (TxDOT funding category 7)
summarized in Appendix 3.
Recommendations
1.
To prevent double taxation, state law should be
amended to prohibit the conversion to toll-road
status of any road on which construction begins
without tolls identified as a funding source.
2.
State law should be amended to prohibit the Texas
Department of Transportation from making allocations
from the Texas Mobility Fund contingent upon the
inclusion of toll roads in regional road plans.
3.
State law should be amended to require commissioners
court approval of any toll road project that will be
built or operated by an RMA in the court’s
jurisdiction.
Current
law does not provide sufficient accountability to
voters for RMA projects. RMAs are, at best,
indirectly accountable to voters, and as the
controversy over CTRMA’s toll plans indicates,
voters do not have a direct relationship to any of
the entities crafting and implementing RMA projects.
County commissioners, however, are directly elected.
Therefore, requiring commissioners courts to approve
RMA projects in their counties would improve
accountability to voters.
In
addition, current law requires that county
commissioners only approve the initial RMA project
as part of the petition to establish the RMA. For a
RMA to be a true state/local partnership,
local authorities should continue to exercise
approval authority over subsequent RMA
transportation projects.
4.
State law should be amended to require the
commissioners courts of each RMA’s constituent
counties to appoint all RMA board members,
including the board’s chair.
If more
than one county jointly petitions TTC to create a
multi-county RMA, the counties’ commissioners should
include a plan for appointing the board’s chair in
their petition.
5.
State law should be amended to allow the
commissioners courts of counties establishing RMAs
to remove any board member, including the board’s
chair.
6.
The Texas Constitution and the Transportation Code
should be amended to require board members of
regional mobility authorities (RMAs) to serve
four-year terms.
Current
law, stipulating six-year terms for RMA board
members, appears to violate the Texas Constitution,
which allows only two-year terms for such local
governing bodies. Furthermore, county commissioners
who serve four-year terms appoint the board members
of RMAs. Making the terms of RMA board members
consistent with the terms of county commissioners
could improve the accountability of such bodies to
elected commissioners courts.
